Application of Raise Boring Machine/Raise Drill

Figure-4-Raise-Boring-Machine-Drilling-Machine-Helius-Tech Joy

1.Application Background

A mine in Pakistan encountered difficulties about community environmental constraints during the development of the vertical shaft.

Vertical shaft parameters: diameter=2m, depth=100m, the shaft has been drilled through the underground to be used as a wind inlet.

Shaft stratum: tight sandstone, limestone, etc. The maximum uniaxial compressive strength of the rock is about 80 MPa.

Environmental restrictions: Due to the environmental constraints of the ground community, it is not allowed to blast, it is impossible to use the traditional drilling and blasting method. Therefore, the solution is needed in this case.

2.Solution

General sequence for the normal construction of shafts is: top-down tunneling. When the wellbore reaches a certain height, the wall is built up down-top, and the tunneling and wall-laying alternate. The process sequence of each section is drilling and blasting firstly, then load out the gangue and rock, and finally build the wall. Due to the limitations of the community environment, it is not possible to use the blasting tunneling, so it is recommended to use the raise boring machine process for vertical shaft development.

3.Construction Process

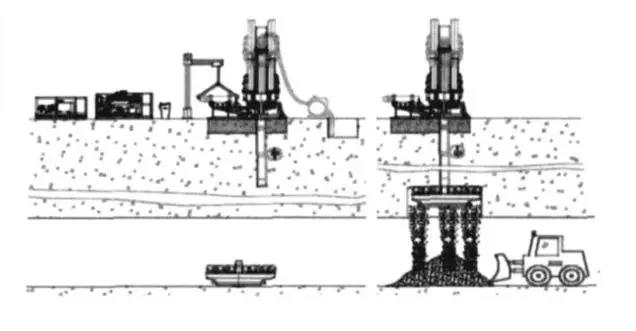

The raise boring machine construction process includes pilot hole drilling and reaming drilling. That is, first drill into the positive guide hole, and then reverse counter-reaming, as shown in Figure 1.

Joy
Figure 1 Schematic diagram of drilling process for positive pilot hole (left) and reverse expansion hole (right)

The principle of the raise boring machine process is to drive the hydraulic motor via the motor of the drilling machine. The hydraulic motor drives the power unit, and torque is transmitted to the drilling tool system via hydraulic power, which drives the drill pipe and the drill bit to rotate. The hob on the drill bit is under the action of the drilling pressure, pure rolling and micro-slip along the working face of the rock at the bottom of the well. At the same time, the axial pull and pressure generated by the main cylinder also pass through the power head, and the drill pipe acts on the drill bit, so that the hob of the drill bit rolls under the action of the drilling pressure, generating an impact load, causing the hob teeth to impact and squeeze the rock. Pressing and shearing, breaking the rock.

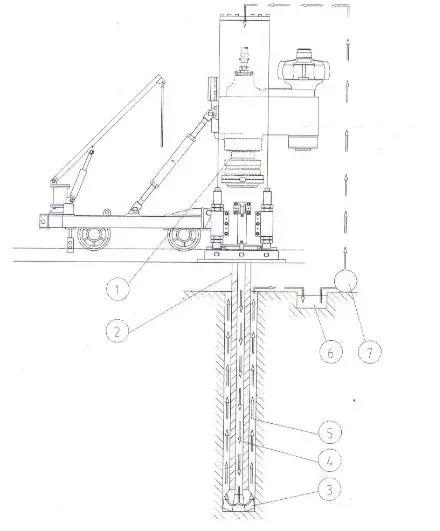

For the pilot hole drilling, the broken rock cuttings are flushed by the circulating circulating washing fluid when the guiding hole is drilled, and the cuttings are lifted from the washing fluid to the outside of the borehole along the annular space between the drill pipe and the hole wall (see in Figure 2).

Joy
Figure 2 Raise Boring Machine Positively Hole Guiding Process
1-power head 2-drill rod 3-channel drill bit 4-mud from mud pump 5-loaded slag mud returned from annular space 6-mud circulation tank 7-mud pump

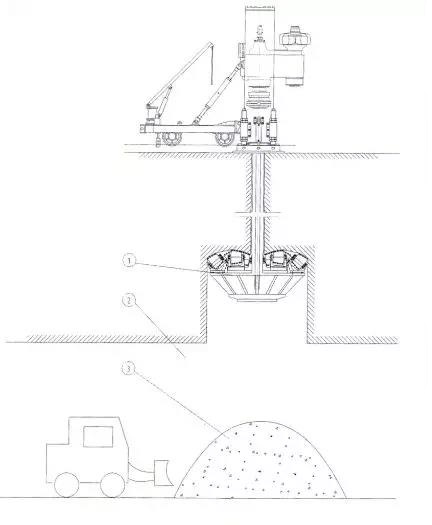

For raise boring machine drilling and tunneling, the rock debris fall directly into the lower roadway by their own weight, and then cleaned out by the mucking machine or other means (as shown in Figure 3).

Joy
Figure 3 Raise Boring Machine Negatively Hole Reaming Process

In this example, ZFY2.5/400 (LM-400) anti-drilling rig is used to drill, first drill 270mm guide hole until the guide hole drills through the lower roadway, then remove the guide hole drill bit, and connect the 2m diameter reaming drill bit. Then, expand the hole down-up.

Figure-4-Raise-Boring-Machine-Drilling-Machine-Helius-Tech Joy

Figure 4 Raise Boring Machine
Figure-5-Reamer-Bit-Raise-Boring-Machine-Drilling-Machine-Helius-Tech Joy

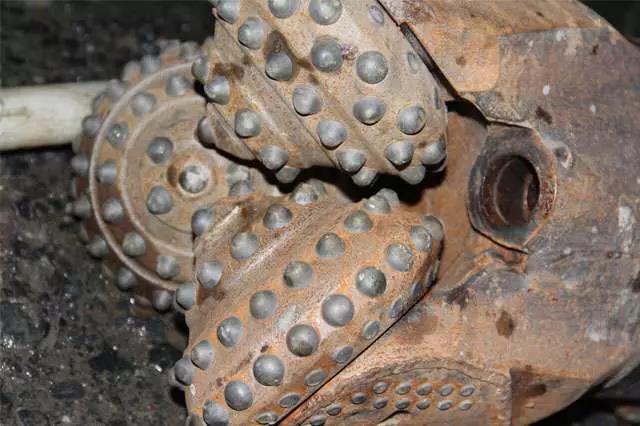

Figure 5 Reamer Bit
Figure-6-Hole-Guiding-Bit-Pilot-Hole-Bit-Raise-Boring-Machine-Drilling-Machine-Helius-Tech Joy
Figure 6 Hole Guiding Bit

Comparison Between Raise Boring Machine Technology and Traditional Blasting Construction Method

* Fast Speed

In the traditional construction method, it is necessary for the staff to carry out eye-catching, firing, slag, support and other operations in each section of the wellbore. Compared with the traditional construction method, the raise-boring machine technology has the following advantages, which can significantly improve the construction progress:

a. Eliminate the process of drilling and blasting.

b. The gangue discharging is handled by the transportation system of the lower roadway, especially when the shaft is deeper, the higher efficiency of raise boring machine.

c. As the personnel do not need to enter the shaft during the construction process, and the lithology which the shaft enters through is tight sandstone and limestone, it is not necessary to support the wall in time to prevent injury.

For example, in the North Second district of Gujiao Malan mine, design diameter is 3m, full height is 112m, with the application of raise boring machine technology, hole guiding time is 56.75h, hole expanding time is 61.5h, 118.26h in total. While compared with similar Zhenchengdi Mine, for 76m main coal bin, the construction operation time period is more than 2 months by using traditional drilling and blasting method.

* High Efficiency

Traditional construction methods of per shift includes drilling hole, blasting, supporting and gangue discharging, which involves exhausting physical labor and difficult working conditions. In the example above of Zhenchengdi Mine, more than 12 people per shift, and advancing speed is 2m per shift. While using raise boring machine, only 4-5 people per shift, advancing rate is 1m per hour. The labor intensity and construction conditions have been fundamentally improved.

* Ensure Safety

Because construction workers don’t enter the shaft, their safety is assured. The deflection rate is less than 1%, and greatly reduces damage for surrounding rocks, thus guarantee the safety.

* Low Cost

Reverse drilling can save a lot of material cost, and personnel costs are lower than traditional construction methods.

Model selection of raise boring machine in this case

* Choose hole drilling and expansion

Twice hole expansion is required if bigger diameter. In this project, the hole drilling depth, dip angle and diameter are confirmed. According to drilling hole parameters to select the reference table, for the project 2m excavation diameter deflection requirements of the project can be drilled once.

* Choose raise boring machine parameter

Although this project only drills 100m, considering actual application and other practical conditions, ZFY2.5/400 (LM-400) raise boring machine is chosen.

Technical parameters of ZFY2.5/400(LM-400) are as below

No.

Description

Unit

Value

1

Pilot hole diameter

Mm

270

2

Expansion hole diameter

Mm

1.4, 2.0, 2.5

3

Hole drilling depth

Mm

400

4

Shaft drilling speed

Rpm

2-21

5

Rated torque

KN.m

80

6

Maximum torque

KN.m

102

7

Maximum thrust

kN

2450

8

Expansion hole maximum tension

kN

3000

9

Drilling hole dip angle

°

60-90

10

Equipment weight(including carrier)

t

12.5

11

Equipment transportation size

Mm

3000*1750*1750

12

Equipment installation size

Mm

4850*1900*5250

13

Rod diameter*active length

Mm

Φ230*1000

14

Borehole deviation slope

%

≤1

15

Motor power

kW

168.5

16

Driven mode

Hydraulic

17

Application lithology

(unidirectional compressive strength)

MPa

140.00

Technical Verification

Due to the maximum downwards thrust of the equipment is 2450KN, which is much larger than the thrust required for the drilling guide hole. To meet the engineering requirement, the expansion tension is verified below:

Actual working tension = Power head weight + hole drill bit weight + drill rod weight + maximum drilling pressure

Among which: power head and cylinder weight 40KN

Hole drill bit weight 25KN

Drill rod weight =155KG/m*400m*9.8N/KG=607.6KN

Maximum drilling pressure can refer to the following table, if speed is 1500mm/h, compressive strength is 80MPa, drilling pressure =477.5kN Then the actual work pulls =40+25+607.6+477.5=1150.1KN

Table 1 (D=2.0m) Relationship between drilling speed and drilling pressure

Rock compressive strength

MPa

Drilling speed=2500

mm/h

2000

1500

1000

500

300

20

205.5kN

183kN

159.2kN

40

367.6kN

318.4kN

249.0kN

80

477.5kN

389.9kN

120

649.8kN

459.5kN

160

643.2kN

498.3kN

It is generally required that the actual working force should not exceed 60% of the maximum lift capacity of the rig. The maximum tensile force for hole expansion of ZFY2.5/400 (LM-400) in this example is 3000KN, and the actual working tensile force/maximum tensile ratio is 38%, which can meet the requirement.
